View Job Costing Across All Projects


The Job Costing page in the left sidebar compares estimated and actual costs for all of your projects in one table, split into Labor, Material and Trade.

Here are the steps to follow:

1

Open Job Costing

Click Job Costing in the left sidebar. Each COG has its own set of columns: Estimated, Actual and Over/Under. Scroll right to see Trade and the Totals columns: Estimated, Actual, Remaining, Variance, Projected Overrun and Complete %.

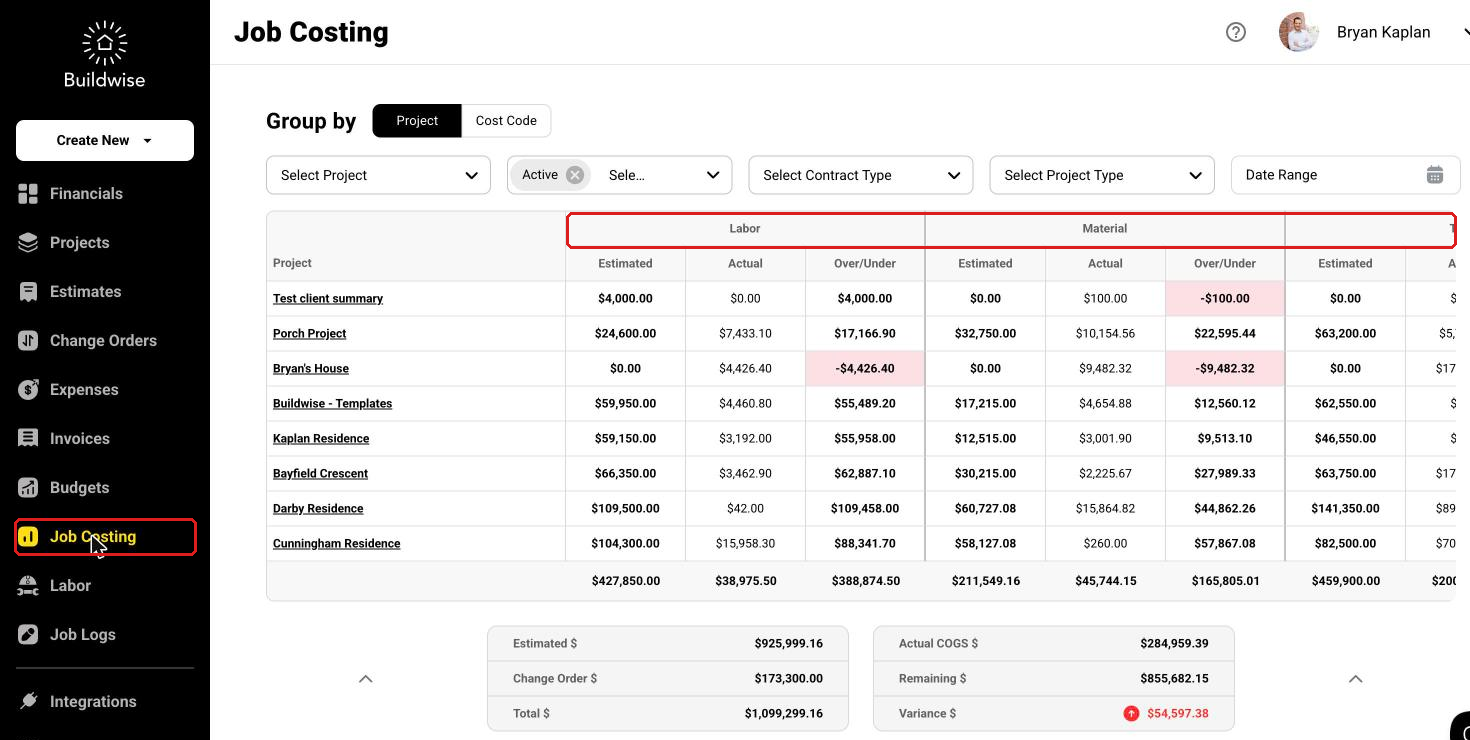

Job Costing in the left sidebar and the Labor, Material and Trade column groups
2

Filter or group the table

Use the same filters as the Budgets page: Select Project, the status filter (starts on Active), Select Contract Type, Select Project Type and Date Range. Under Group by, click Cost Code to see one row per cost group instead of one row per project. Picking a project clears the other filters, so that project always shows. Date Range only limits expenses. Approved estimates and change orders always count in full. Unbillable expenses on Cost Plus projects are never counted on this page.

3

Read Over/Under

Over/Under is Estimated minus Actual. A red cell means the actual cost is higher than the estimate. As an example, $0.00 estimated and $100.00 actual shows -$100.00 in red.

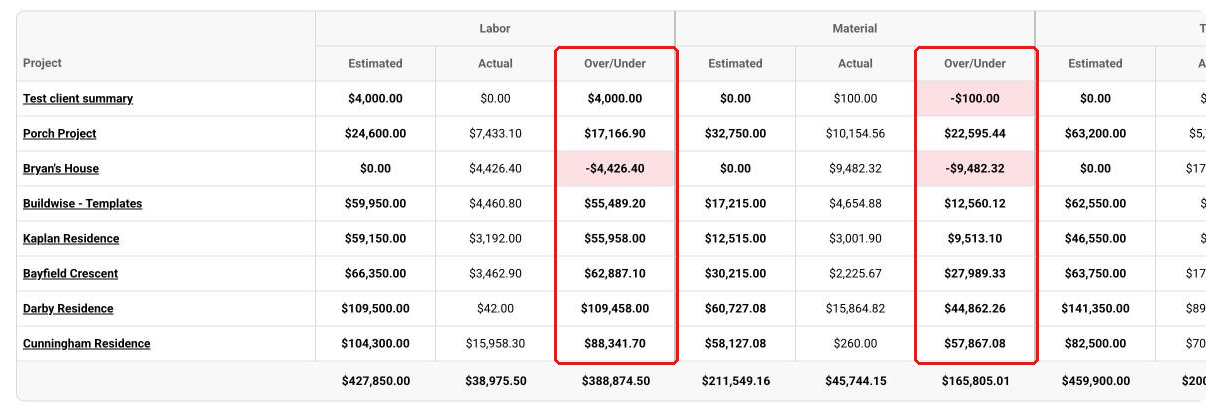

The Over/Under columns for Labor and Material
4

Check the totals

The bold row at the bottom of the table adds up every row. The summary bar under the table shows Estimated $, Change Order $, Total $, Actual COGS $, Remaining $ and Variance $ for everything in the table. Variance $ is red with an up arrow when you are over budget, and green with a down arrow when a cost group was marked complete under budget. Click a project name to open that project's Job Costing tab.

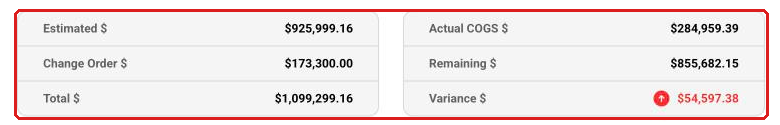

The summary totals under the Job Costing table

What the Totals columns show

Column What it shows
Estimated Approved estimates and change orders, before markup and tax.
Actual Expenses so far, before markup and tax. On Cost Plus projects, unbillable expenses are left out.
Remaining Estimated minus Actual. On Cost Plus projects it never goes below $0.00. It is $0.00 once the cost group is marked complete.
Variance How far over budget a cost group is. While a cost group is open, it stays $0.00 until Actual goes over Estimated. Once the group is marked complete, it shows the final difference, which is negative if you finished under budget.
Projected Overrun See How Projected Overrun works, below.
Complete % Actual divided by Estimated. It can go above 100%.

How Projected Overrun works

Why it is there: Variance looks at the whole cost group. If Labor is over budget but Material still has money left, the leftover Material money covers the Labor overspend, so Variance stays at $0.00 and the cost group looks fine. Projected Overrun is there to find these problems hiding in plain sight, early, before the leftover money runs out.

How it is worked out: Buildwise adds up how far each of Labor, Material and Trade is over its own estimate. It does not include Variance which includes cost groups and cost items where there is spend but no estimate or change orders.

As an example, a cost group with Labor estimated at $10,000.00 and Material at $5,000.00:

Labor Material Totals Over budget
Estimated Actual Estimated Actual Estimated Actual Variance Projected Overrun
Example 1 $10,000 $12,000 $5,000 $2,000 $15,000 $14,000 $0 $2,000
Example 2 $10,000 $16,000 $5,000 $2,000 $15,000 $18,000 $3,000 $3,000

Example 1: Labor is $2,000.00 over, but the cost group in total is under its estimate. Variance is $0.00, so Projected Overrun shows the $2,000.00.

Example 2: Labor is $6,000.00 over and the cost group in total is $3,000.00 over. Variance shows $3,000.00, so Projected Overrun shows the rest: $6,000.00 minus $3,000.00 = $3,000.00.

Add Variance and Projected Overrun together to see everything that is over budget. Projected Overrun is $0.00 once the cost group is marked complete. It shows on this page and on the Job Costing and Budget tabs of a Cost Plus project. A Fixed Cost project's own Job Costing tab does not show it.

For the budget view, see View Budgets Across All Projects.

If you have any questions or need support:

💬 Click the beacon on this page to chat with us
📩 Click the beacon on this page to email us

Did this answer your question? Thanks for the feedback There was a problem submitting your feedback. Please try again later.

Still need help? Contact Us Contact Us
